Concept illustration of an unlit thermostat and dial beside a softly lit bedroom
AI-generated room-control illustration. Check the thermostat and AC interface together before installation.
Automation

HVAC control without the daily guesswork

HVAC automation should let you set a comfortable room without fighting the AC controls. We check what your equipment supports, then plan schedules and room modes around occupancy. A promised app feature is not a substitute for a confirmed interface.

Quick answer

What does HVAC automation control?

HVAC automation can schedule operation, adjust approved setpoints, respond to occupancy and show available status. The exact control depends on the manufacturer interface. Infrared commands, dry contacts, gateways and BACnet points expose very different levels of feedback.

Project management consultancy (PMC)

What does HVAC automation PMC coordinate?

HVAC controls PMC can help the mechanical contractor and automation vendor agree who controls each function. Resolve that boundary before buying gateways or changing thermostats.

For one standalone AC, its own controller may be enough. Integration becomes useful when several zones need to work together.

  1. Confirm supported control

    Record the equipment models and available commands, feedback and gateway requirements.

  2. Agree room behaviour

    Write occupied and setback modes with allowed setpoints and local overrides.

  3. Commission together

    Witness commands and status with the HVAC contractor, including restart and communication-loss behaviour.

Manufacturer protections stay in charge. This scope does not replace mechanical design or promise a particular energy reduction.

Discuss the scope with us

Understand

Check the dependencies around HVAC automation

Read the adjacent technical page before choosing equipment. It may change the wiring, network or control method that belongs in the brief.

Read the related guide

How to think about it

Sending an AC command is easy. Knowing whether the unit received it is harder. A one-way infrared blaster may imitate a remote, while a documented gateway can expose mode, setpoint and fault data if the equipment supports those points.

What should we decide before ordering?

Who owns the temperature loop?

The equipment controller normally protects compressors, fans and plant sequences. The automation layer should request permitted modes or setpoints rather than bypassing those safeguards.

A points schedule records which values are monitored, which are writable and which remain under the HVAC vendor.

How are occupancy and schedules applied?

Occupancy can shift setpoints or release a room after a delay. It should not cause rapid cycling, erase a user override or contradict ventilation requirements.

The sequence is reviewed with the mechanical team. Comfort complaints are operational evidence, not merely a dashboard problem.

What does the work involve?

What can split AC integration do?

Capabilities range from one-way infrared commands to manufacturer gateways with state feedback. The exact indoor-unit model and interface list are checked before the proposal names any feature. Remote-controller behaviour is tested alongside the automation command path.

What changes with central HVAC?

Central systems introduce plant controllers, valves, dampers, sensors and operating sequences. SmartR Spaces can integrate agreed building-control points; mechanical design and balancing remain separate responsibilities.

What happens when the gateway is offline?

Local thermostats or equipment controls should retain an agreed mode where the architecture allows it. The handover states the fallback, alarm path and method for restoring communications.

Where do HVAC automation cost and responsibility sit?

Budget is driven by zone count, thermostat or sensor points, gateway availability, valve or damper actuators, plant interfaces, trend requirements and mechanical commissioning support. Native manufacturer controls may be the best option for a small standalone system. A building or room automation layer is justified when occupancy, scheduling, monitoring or coordinated modes need to span several pieces of equipment.

Work starts by documenting the mechanical sequence and supported interface, then mapping points, limits and alarm ownership. Record who may change each setpoint and schedule. After installation, each command and status is tested with the mechanical contractor, followed by occupied, standby, override and restart cases. Maintenance includes sensor checks, setpoint and schedule review, trend inspection and gateway backup. Manufacturer safeties remain authoritative. If the supervisory controller or internet fails, local equipment control should follow the approved fallback rather than accept stale remote commands.

What does temperature-based automation control?

Temperature is only one input. Temperature-based automation may adjust an approved thermostat setpoint or request a supported air-conditioner or central HVAC mode, but equipment safeties, condensation limits, ventilation needs and the mechanical designer's sequence remain authoritative.

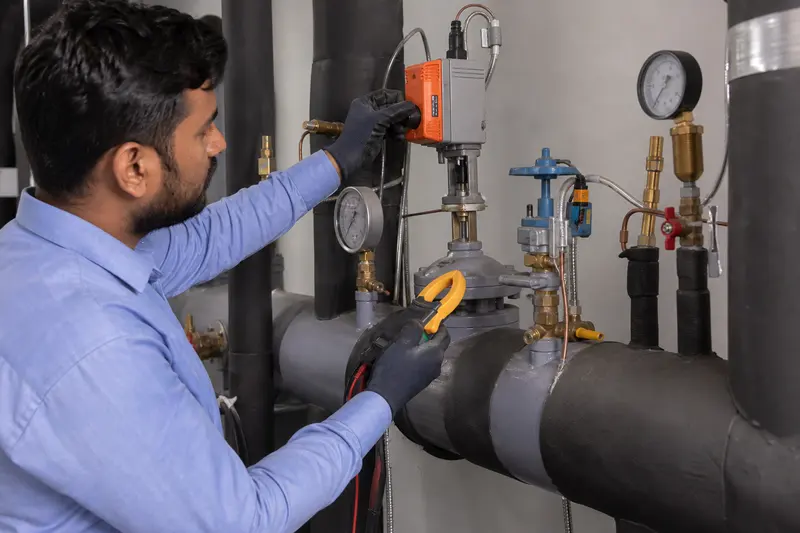

Technician inspects an actuated chilled-water control valve and associated sensors.
Concept illustration: Technician inspects an actuated chilled-water control valve and associated sensors.

How the system works

HVAC integration and equipment boundary: Room-layer request, Supported interface, Equipment controller, Plant, Equipment safeties
A functional boundary separates a room-layer request and supported interface from the equipment controller, plant and equipment safeties. A separate supported status or alarm path returns through the interface to the room layer; room requests must not bypass equipment safeties.
Example HVAC occupancy-mode selection: Schedule and presence, Temporary override, Mode priorities, Occupied, Standby, Unoccupied
Schedule and presence inputs, together with any permitted temporary override, feed the agreed mode-priority evaluation. Occupied, standby and unoccupied are alternative selected modes, not inevitable sequential stages. Override expiry or cancellation returns to the input checks.

Comparison and decision tables

HVAC interface trade-offs
InterfaceFeedbackMain limitation
Infrared commandOften none or inferredState can drift from the real unit
Dry contactLimited stateUsually coarse enable or mode control
Documented gateway or BACnetModel-dependent pointsNeeds verified compatibility and mapping

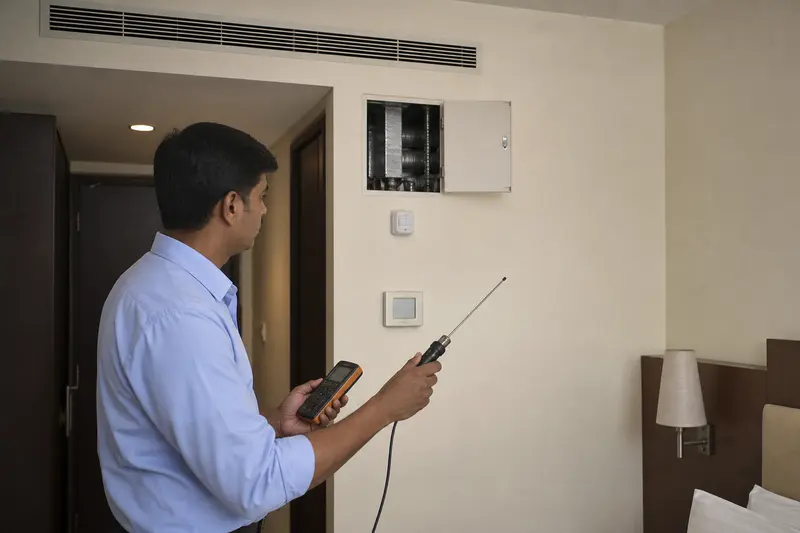

Engineer measures room conditions beside hotel fan-coil controls and a blank thermostat.
Concept illustration: Engineer measures room conditions beside hotel fan-coil controls and a blank thermostat.

Evaluate

Turn the HVAC automation brief into drawings

Bring the floor plan, reflected ceiling plan or equipment schedule. We can mark assumptions, interfaces and unresolved choices before procurement.

Request a design review

Editorial information

Written by: SmartR Spaces

Technical review: M&M Smarter Automation LLP

Content updated:

Sources

Next step

Discuss a scoped HVAC automation project

A useful proposal starts with the property, expected behaviour and handover standard. Product names come after those decisions.

Book a consultation
